Diodes Ap62300twu-evm Cot Synchronous Dc-dc Buck Converter Instruction Manual

Diodes Ap62300twu-evm Cot Synchronous Dc-dc Buck Converter Instruction Manual

DIODES-LOGO

DIODES AP62300TWU-EVM COT Synchronous DC-DC Buck Converter

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-PRODUCT

Product Information

Product Name: AP62300TWU-EVM

Description: The AP62300TWU-EVM is an 18V, 3A, low Iq, COT synchronous DC-DC buck converter. It is designed to provide high-efficiency step-down DC-DC conversion with a wide input voltage range of 4.2V to 18V. The device integrates a high-side power MOSFET and a low-side power MOSFET for easy usage and minimal external component count. It features Constant On-Time (COT) control for fast transient response, easy loop stabilization, and low output voltage ripple. The design is optimized for EMI reduction and features a proprietary gate driver scheme to minimize high-frequency radiated EMI noise.

Features

  • Proprietary Gate Driver Design for Best EMI Reduction
  • Undervoltage Lockout (UVLO)
  • Cycle-by-Cycle Valley Current Limit
  • Thermal Shutdown Protection Circuitry
  • Totally Lead-Free & Fully RoHS Compliant
  • Halogen and Antimony Free

Applications:

  • Flat Screen TV Sets and Monitors
  • Consumer Electronics
  • Network Systems
  • General Purpose Point of Load

DESCRIPTION

The AP62300T is a 3A, synchronous buck converter with a wide input voltage range of 4.2V to 18V. The device fully integrates a 75mΩ high-side power MOSFET and a 45mΩ low-side power MOSFET to provide high-efficiency step-down DC-DC conversion. The AP62300T device is easily used by minimizing the external component count due to its adoption of Constant On-Time (COT) control to achieve fast transient response, easy loop stabilization, and low output voltage ripple. The AP62300T design is optimized for Electromagnetic Interference (EMI) reduction. The device has a proprietary gate driver scheme to resist switching node ringing without sacrificing MOSFET turn-on and turn-off times, which reduces high-frequency radiated EMI noise caused by MOSFET switching. AP62300T is available in a TSOT26 package.

FEATURES

  • VIN Range: 4.2V -18V
  • Output Voltage range: 0.8V to 7V
  • 3A Continuous Output Current
  • 0.763V ± 1% Reference Voltage (TA = +25°C) => AP62300T
  • 155μA Low Quiescent Current
  • 750kHz Switching Frequency
  • Up to 83% Efficiency at 5mA Light Load
  • Proprietary Gate Driver Design for Best EMI Reduction
  • Protection Circuitry
    • Undervoltage Lockout (UVLO)
    • Cycle-by-Cycle Valley Current Limit
    • Thermal Shutdown
  • Totally Lead-Free & Fully RoHS Compliant
  • Halogen and Antimony Free. “Green” Device

APPLICATIONS

  • Flat Screen TV Sets and Monitors
  • Consumer Electronics
  • Network Systems
  • General Purpose Point of Load

OPERATING CONDITIONS

ABSOLUTE MAXIMUM RATINGS

SymbolParameterRatingUnit
VINSupply Pin Voltage-0.3 to +20.0 (DC)V
-0.3 to 22.0 (400ms)
VSWSwitch Pin Voltage-1.0 to VIN + 0.3 (DC)V
-2.5 to VIN + 2.0 (20ns)
VBSTBootstrap Pin VoltageVSW – 0.3 to VSW + 6.0V
VENEnable/UVLO Pin Voltage-0.3 to +6.0V
VFBFeedback Pin Voltage-0.3 to +6.0V
TSTStorage Temperature-65 to +150°C
TJJunction Temperature+150°C
TLLead Temperature+260°C
ESD Susceptibility
HBMHuman Body Mode2000V
CDMCharge Device Model500V

RECOMMENDED OPERATING CONDITIONS

SymbolParameterRatingUnit
VINSupply Voltage4.2 to 18V
VOUTOutput Voltage Range0.8 to 7V
TAOperating Ambient Temperature

-40 to +85

°C
TJOperating Junction Temperature

-40 to +125

°C

SETTING OUTPUT VOLTAGE

Table 1 for AP62300T shows a list of recommended component selections for common output voltages.

Table 1. Common Output Voltages

VOUTC1C2, C3R1R2L1C6
1.2V10µF2 x 22µF5.76KΩ10KΩ1.5µH100nF
1.5V10µF2 x 22µF9.76KΩ10KΩ1.5µH100nF
1.8V10µF2 x 22µF13.7KΩ10KΩ2.2µH100nF
2.5V10µF2 x 22µF22.6KΩ10KΩ2.2µH100nF – 220nF
3.3V10µF2 x 22µF33.2KΩ10KΩ3.3µH100nF – 330nF
5.0V10µF2 x 22µF56.2KΩ10KΩ3.3µH100nF – 330nF

EVALUATION BOARD

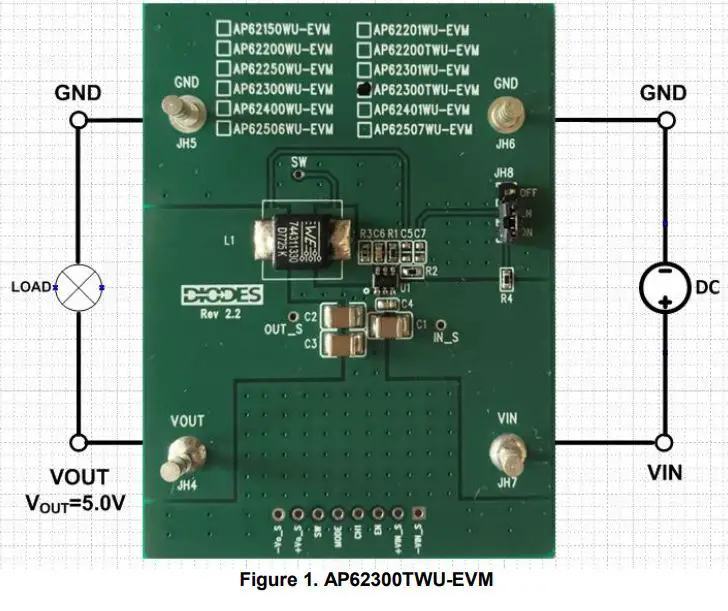

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-1

QUICK START GUIDE

The AP62300TWU-EVM has a simple layout and allows access to the appropriate signals through test points. To evaluate the performance of the AP62300TWU, follow the procedure below:

  1. Connect a power supply to the input terminals VIN and GND. Set VIN to 12V.
  2. Connect the positive terminal of the electronic load to VOUT and negative terminal to GND.
  3. For Enable, place a jumper at JH8 to “ON” position to connect EN pin to VIN through 100KΩ resistor to enable IC or leave it OPEN. Jump to “OFF” position to disable IC.
  4. The evaluation board should now power up with a 5.0V output voltage.
  5. Check for the proper output voltage of 5.0V (±1%) at the output terminals VOUT and GND. Measurement can also be done with a multimeter with the positive and negative leads between VOUT and GND.
  6. Set the load to 3A through the electronic load. Check for the stable operation of the SW signal on the oscilloscope. Measure the switching frequency.

MEASUREMENT/PERFORMANCE GUIDELINES

  1. When measuring the output voltage ripple, maintain the shortest possible ground lengths on the oscilloscope probe. Long ground leads can erroneously inject high-frequency noise into the measured ripple.
  2. For efficiency measurements, connect an ammeter in series with the input supply to measure the input current. Connect an electronic load to the output for output current.

BOOTSTRAP CAPACITOR GUIDELINES

To ensure proper operation, a ceramic capacitor must be connected between the BST and SW pins to supply the drive voltage for the high-side power MOSFET. A 100nF ceramic capacitor is sufficient for most applications. In the cases where output voltage is higher than 2.5V, a higher capacitance is recommended to help maintain stable voltage from BST to SW. Please refer to Table 1 for details.

EVALUATION BOARD SCHEMATIC

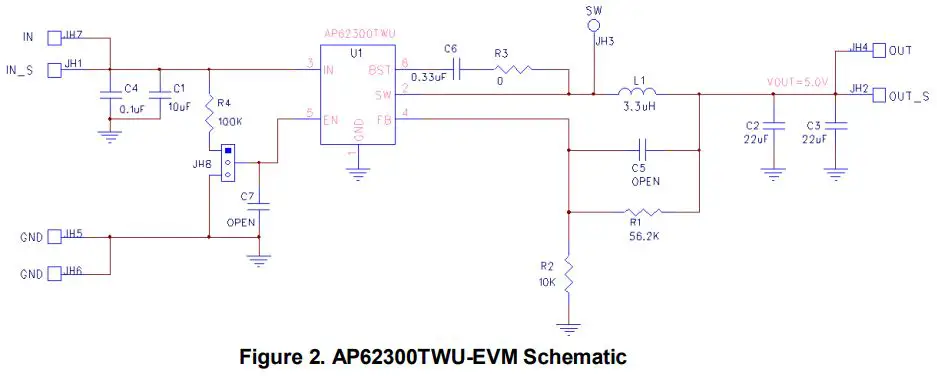

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-2

PCB TOP LAYOUT

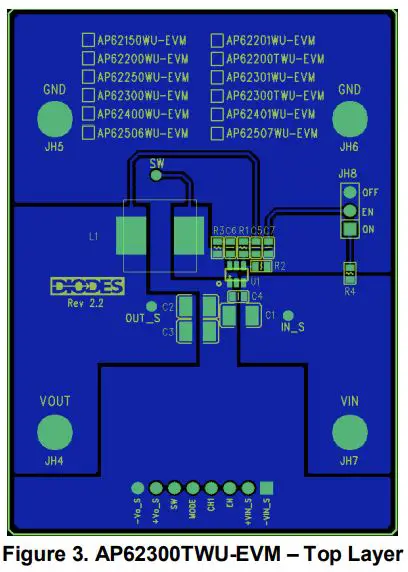

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-3

PCB BOTTOM LAYOUT

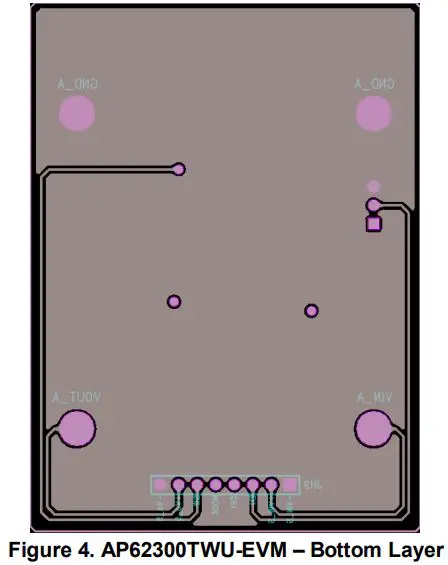

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-4

BILL OF MATERIALS for AP62300TWU-EVM for VOUT=5V

RefValueDescriptionQtySizeVendor NameManufacturer PN


C1



10µF

Ceramic Capacitor,

25V, X5R



1



1210



Murata

GRM32DR61E106KA12

L



C2, C3



22µF

Ceramic Capacitor, 25V, X5R

2



1210



AVX



12103D226KAT2A



C4



0.1µF

Ceramic Capacitor,

50V, X7R, 10%



1



0603



Murata

GCJ188R71H104KA12

D



C6



0.33µF

Ceramic Capacitor, 16V, X7R, 10%

1



0603



Samsung



CL10B334KO8NNNC



L1



3.3µH

DCR=10.5mΩ, Ir=7.5A

1

10x10x 5mmWurth Electronics

7447714033

R156.2KΩSMD Resistor, 1%10603PanasonicERJ-3EKF5622V
R210KΩSMD Resistor, 1%10603PanasonicERJ-3EKF1002V
R3SMD Resistor, 1%10603PanasonicERJ-3GEY0R00V


R4



100KΩ



SMD Resistor, 1%



1



0603



Panasonic



ERJ-3EKF1003V

JH4, JH5, JH6,

JH7





1598



Terminal Turret

Triple 0.094″ L (Test Points)





4



Through- Hole



Keystone Circuit





1598-2



JH8

 PCB Header, 40

POS



1



1X3



3M



2340-6111TG





U1





AP62300T



Sync Buck

DC-DC converter





1





TSOT26



Diodes Incorporated





AP62300TWU-7

TYPICAL PERFORMANCE CHARACTERISTICS

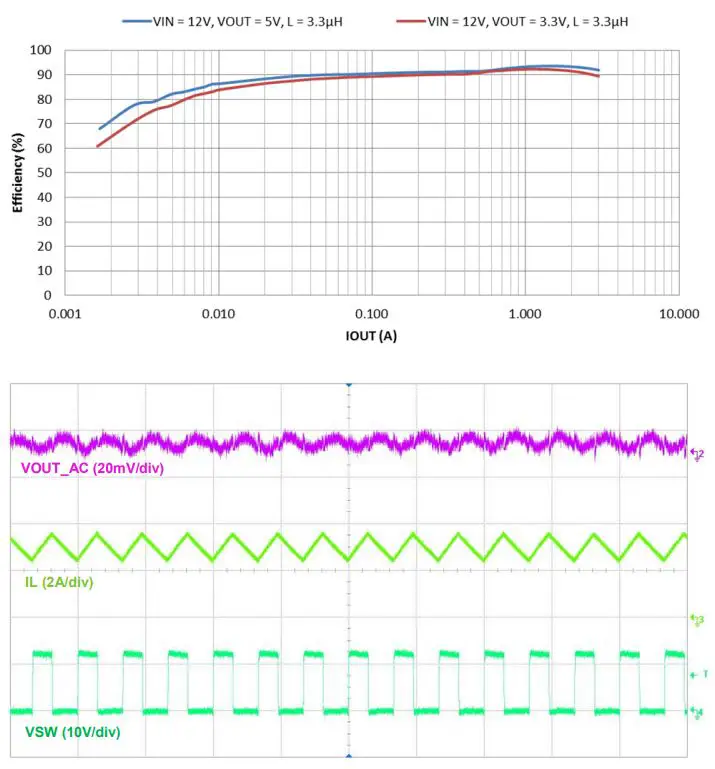

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-5

UVP OPERATION

UVP is known as Undervoltage Protection. It is a comparator that monitors the output voltage. UVP is intended to assist the OCP (overcurrent protection). In the event that the output is overloaded, then its voltage will drop. At the point when VFB is 495mV, then the LS FET will discharge the output and the regulator will enter hiccup mode to reduce power dissipation. Likewise, the UVP will occur to prevent damage if the output is shorted to ground.

RECOMMENDATION OF ACHIEVING HIGH VIN UVLO THRESHOLD VOLTAGE

DIODES-AP62300TWU-EVM-COT-Synchronous-DC-DC-Buck-Converter-FIG-6

  • For output voltage >4V, it is best to add a resistor at R5 of EN equal to 25KΩ in the resistive divider network so that the turn-off voltage occurs at 4.8V while turn-on voltage occurs at 5.9V. Please refer to the schematic below for higher VIN UVLO threshold in details.

IMPORTANT NOTICE

  1. DIODES INCORPORATED (Diodes) AND ITS SUBSIDIARIES MAKE NO WARRANTY OF ANY KIND, EXPRESS OR IMPLIED, WITH REGARDS TO ANY INFORMATION CONTAINED IN THIS DOCUMENT, INCLUDING, BUT NOT LIMITED TO, THE IMPLIED WARRANTIES OF MERCHANTABILITY, FITNESS FOR A PARTICULAR PURPOSE OR NON-INFRINGEMENT OF THIRD PARTY INTELLECTUAL PROPERTY RIGHTS (AND THEIR EQUIVALENTS UNDER THE LAWS OF ANY JURISDICTION).
  2. The Information contained herein is for informational purpose only and is provided only to illustrate the operation of Diodes’ products described herein and application examples. Diodes does not assume any liability arising out of the application or use of this document or any product described herein. This document is intended for skilled and technically trained engineering customers and users who design with Diodes’ products. Diodes’ products may be used to facilitate safety-related applications; however, in all instances customers and users are responsible for (a) selecting the appropriate Diodes products for their applications, (b) evaluating the suitability of Diodes’ products for their intended applications, (c) ensuring their applications, which incorporate Diodes’ products, comply the applicable legal and regulatory requirements as well as safety and functional-safety related standards, and (d) ensuring they design with appropriate safeguards (including testing, validation, quality control techniques, redundancy, malfunction prevention, and appropriate treatment for aging degradation) to minimize the risks associated with their applications.
  3. Diodes assumes no liability for any application-related information, support, assistance or feedback that may be provided by Diodes from time to time. Any customer or user of this document or products described herein will assume all risks and liabilities associated with such use, and will hold Diodes and all companies whose products are represented herein or on Diodes’ websites, harmless against all damages and liabilities.
  4. Products described herein may be covered by one or more United States, international or foreign patents and pending patent applications. Product names and markings noted herein may also be covered by one or more United States, international or foreign trademarks and trademark applications. Diodes does not convey any license under any of its intellectual property rights or the rights of any third parties (including third parties whose products and services may be described in this document or on Diodes’ website) under this document.
  5. Diodes’ products are provided subject to Diodes’ Standard Terms and Conditions of Sale (https://www.diodes.com/about/company/terms-and-conditions/terms-and-conditions-of-sales/) or other applicable terms. This document does not alter or expand the applicable warranties provided by Diodes. Diodes does not warrant or accept any liability whatsoever in respect of any products purchased through unauthorized sales channel.
  6. Diodes’ products and technology may not be used for or incorporated into any products or systems whose manufacture, use or sale is prohibited under any applicable laws and regulations. Should customers or users use Diodes’ products in contravention of any applicable laws or regulations, or for any unintended or unauthorized application, customers and users will (a) be solely responsible for any damages, losses or penalties arising in connection therewith or as a result thereof, and (b) indemnify and hold Diodes and its representatives and agents harmless against any and all claims, damages, expenses, and attorney fees arising out of, directly or indirectly, any claim relating to any noncompliance with the applicable laws and regulations, as well as any unintended or unauthorized application.
  7. While efforts have been made to ensure the information contained in this document is accurate, complete and current, it may contain technical inaccuracies, omissions and typographical errors. Diodes does not warrant that information contained in this document is error-free and Diodes is under no obligation to update or otherwise correct this information. Notwithstanding the foregoing, Diodes reserves the right to make modifications, enhancements, improvements, corrections or other changes without further notice to this document and any product described herein. This document is written in English but may be translated into multiple languages for reference. Only the English version of this document is the final and determinative format released by Diodes.
  8. Any unauthorized copying, modification, distribution, transmission, display or other use of this document (or any portion hereof) is prohibited. Diodes assumes no responsibility for any losses incurred by the customers or users or any third parties arising from any such unauthorized use.
  9. This Notice may be periodically updated with the most recent version available at https://www.diodes.com/about/company/terms-and-conditions/important-notice

The Diodes logo is a registered trademark of Diodes Incorporated in the United States and other countries.
All other trademarks are the property of their respective owners. © 2023 Diodes Incorporated. All Rights Reserved.

www.diodes.com
