Karibu Garden House Noorvik Extension Roof

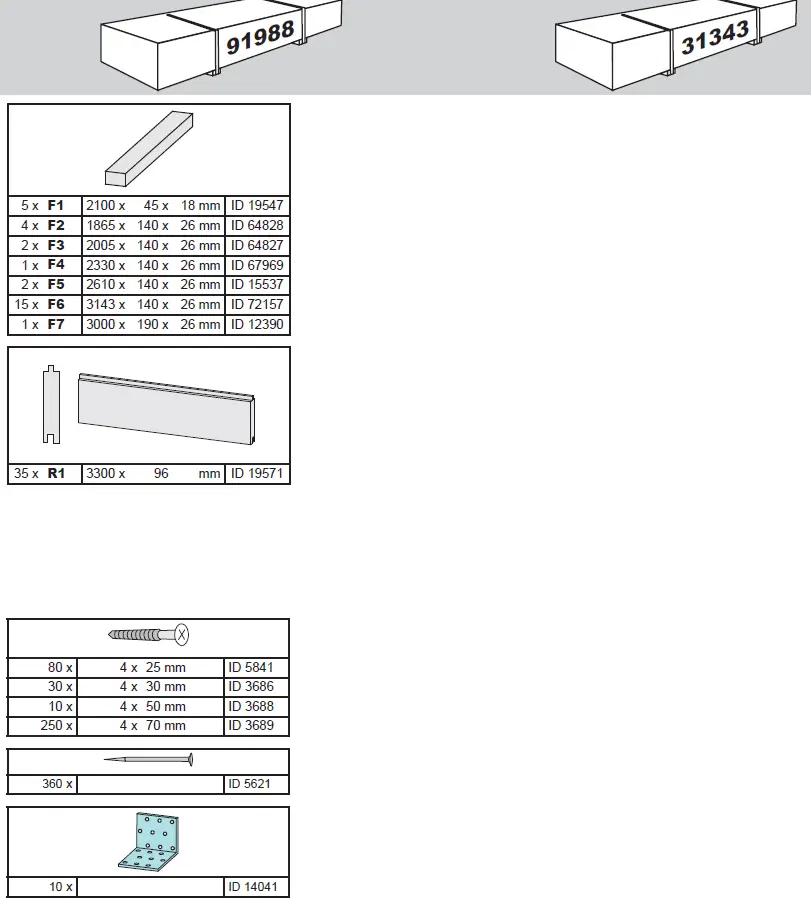

TOOLS REQUIRED

First compare the list of materials with your package contents! Please understand that complaints can be processed in the non-built status only!

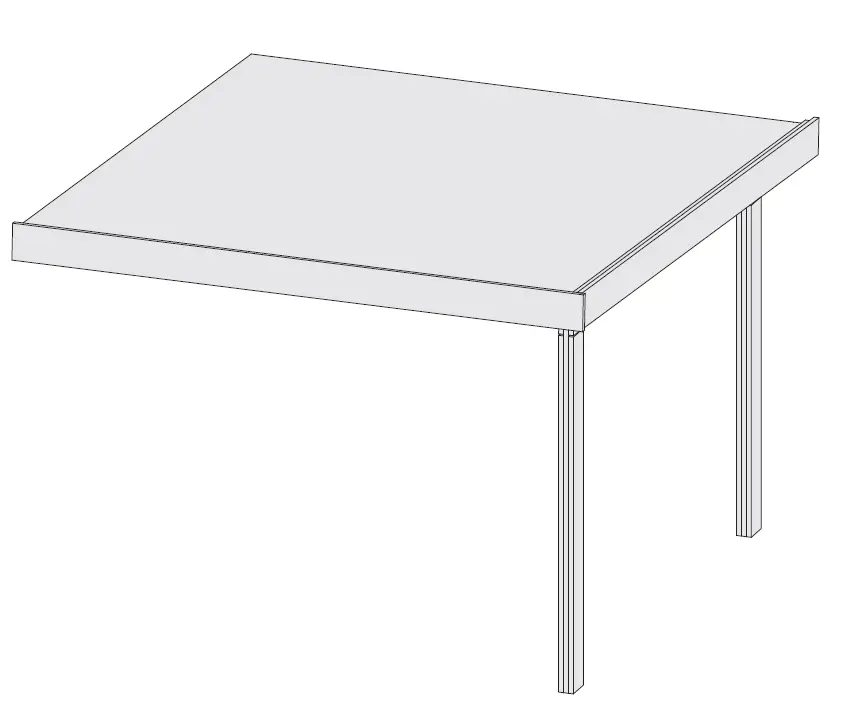

Overview

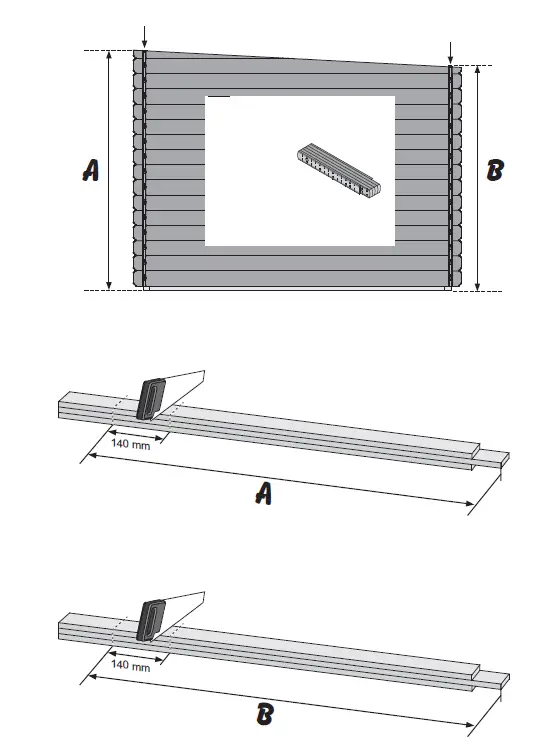

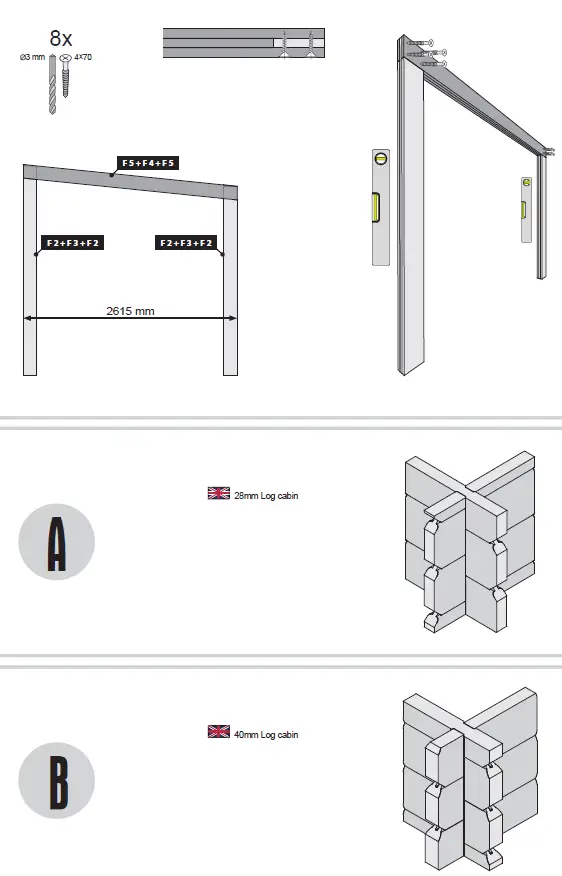

Length must be determined and sawn

INSTRUCTION

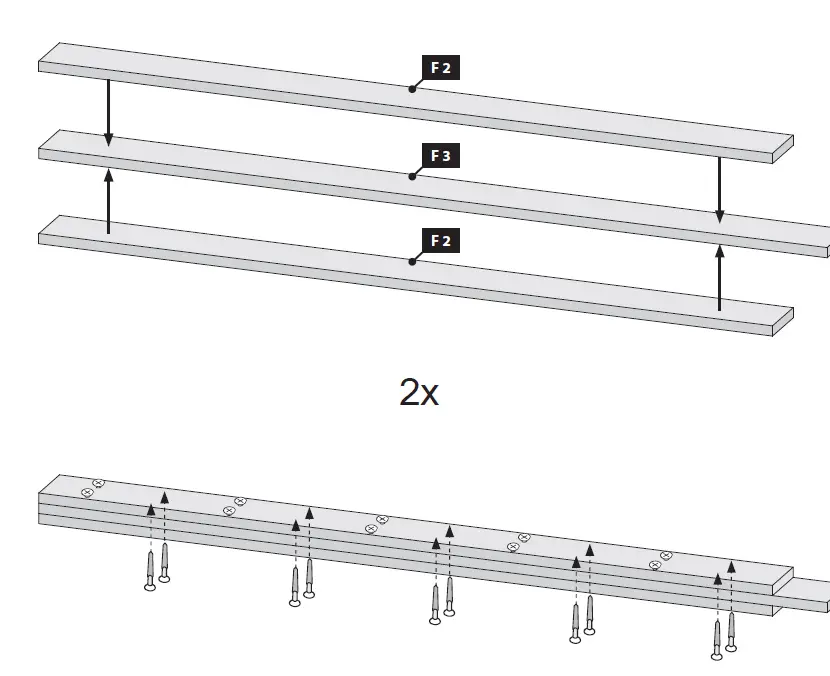

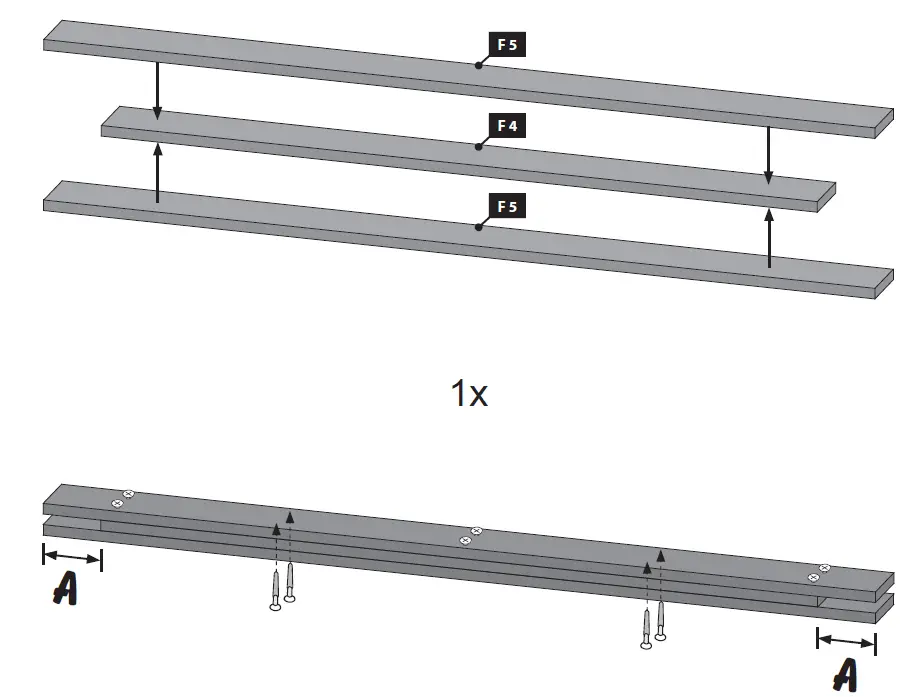

Flush

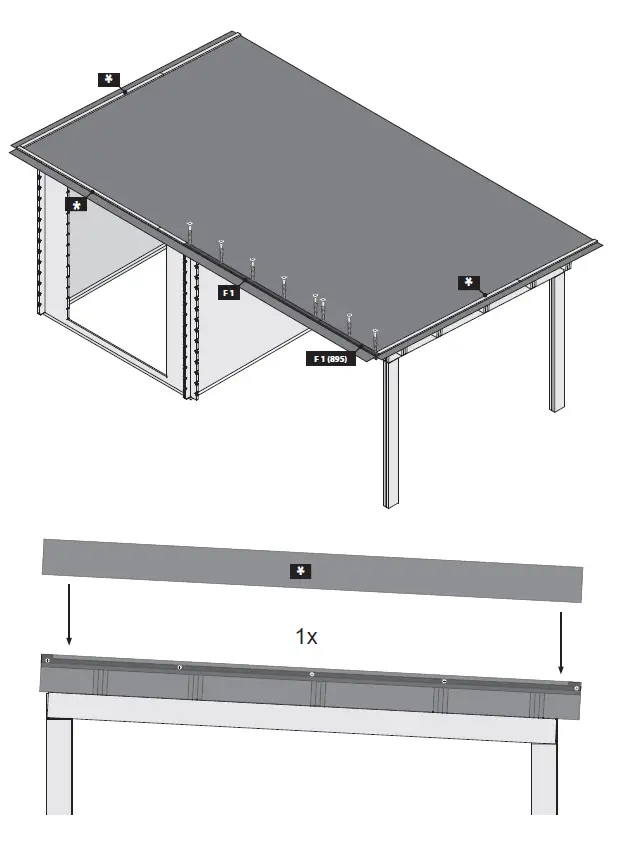

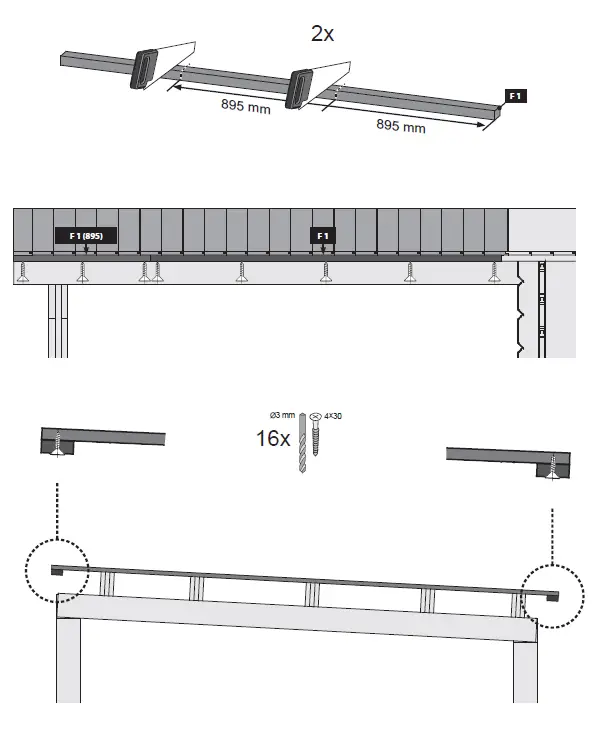

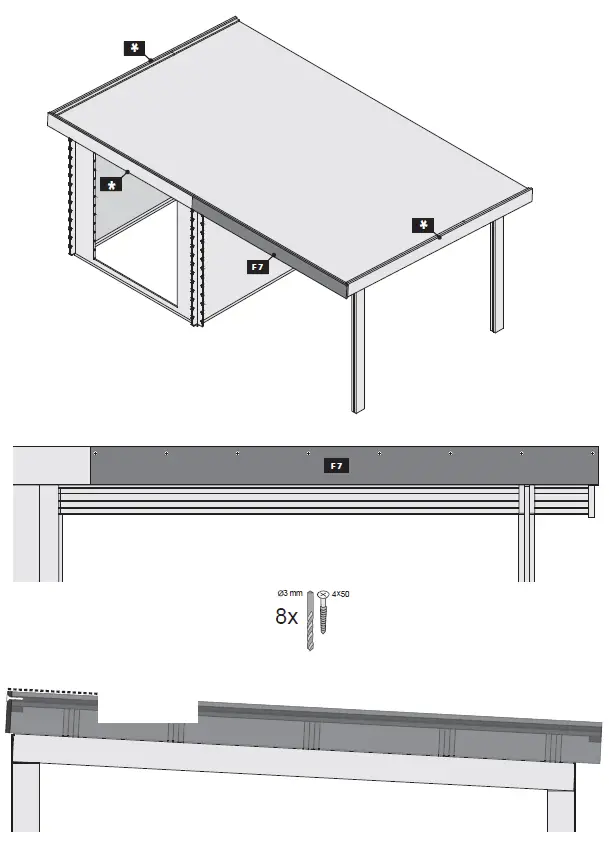

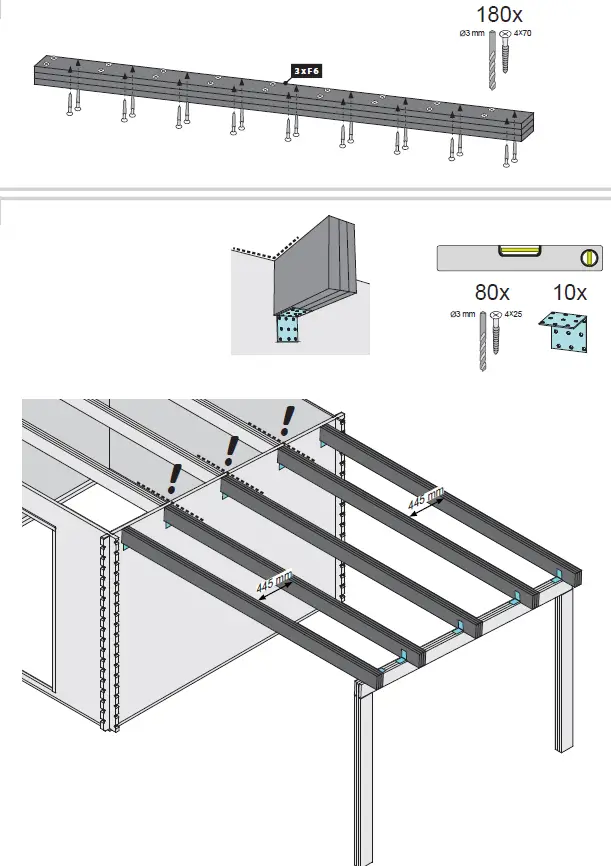

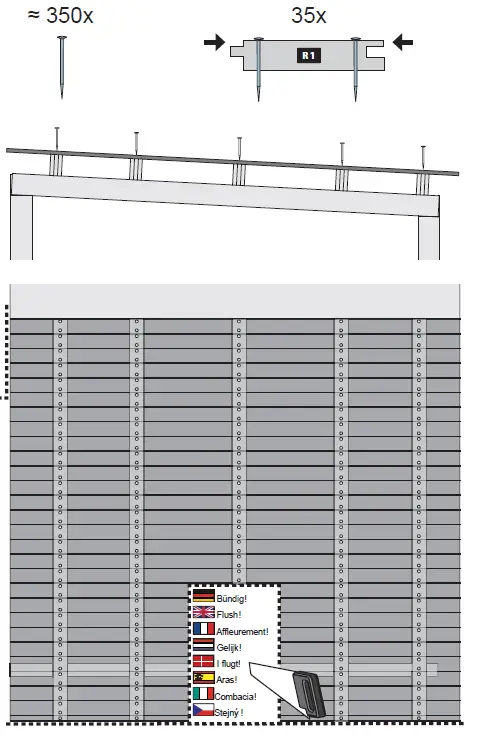

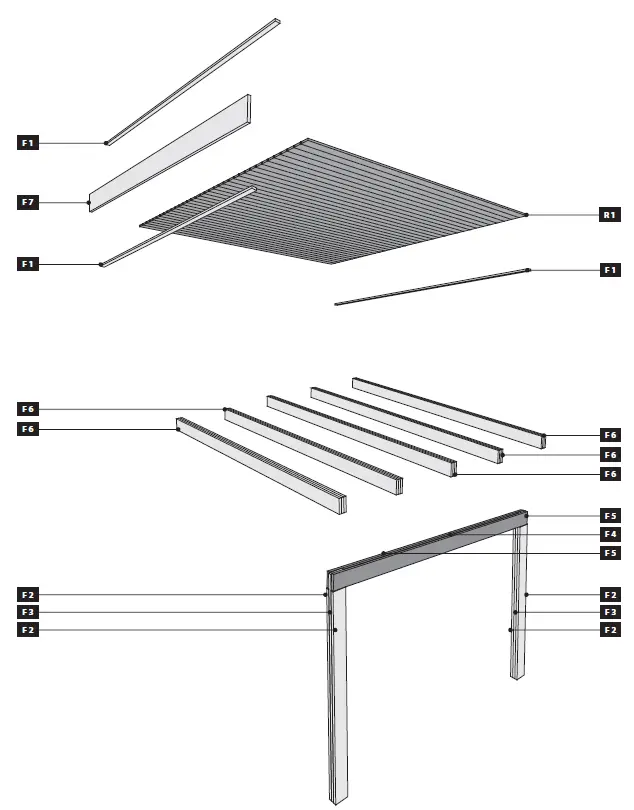

Mounting roof

Note! This description is only an example

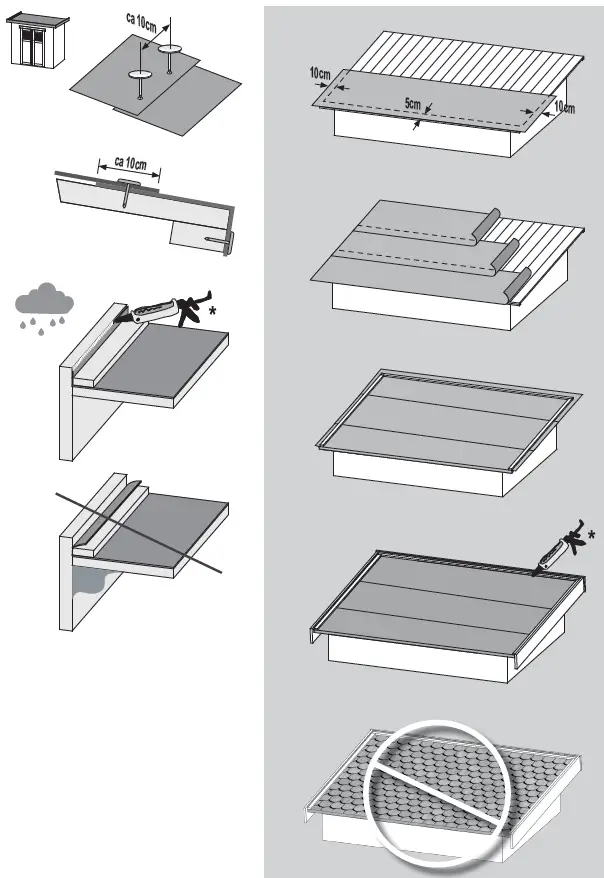

The bitumen roofing is used for initial cover and should be supplemented by a separate product according to customers choice after two months. The number of bitumen strips to be used depends on your actual house size. When joining rolls of roofing felt end to end, the overlap must be aproxximately 10cm. The roof is not safe to walk on. The roof is designed for a total load (snow, wind) and not for a point load. We recommend you to always support the roof from below during installation. The sealing of the roof surfaces to adjacent components with bitumen sealant has to be effected by the customer! If it is a saddle-roofed house, do not use roofing tiles for roofing. In this case, a 20 cm wide strip of bitumen with overhang should be installed on both sides of the eaves. For houses with a tonne roof, please install a bitumen roofing under the shingles. In the case of a flat roof the laying of roof shingles is not possible!
Not included! Protect from moisture
